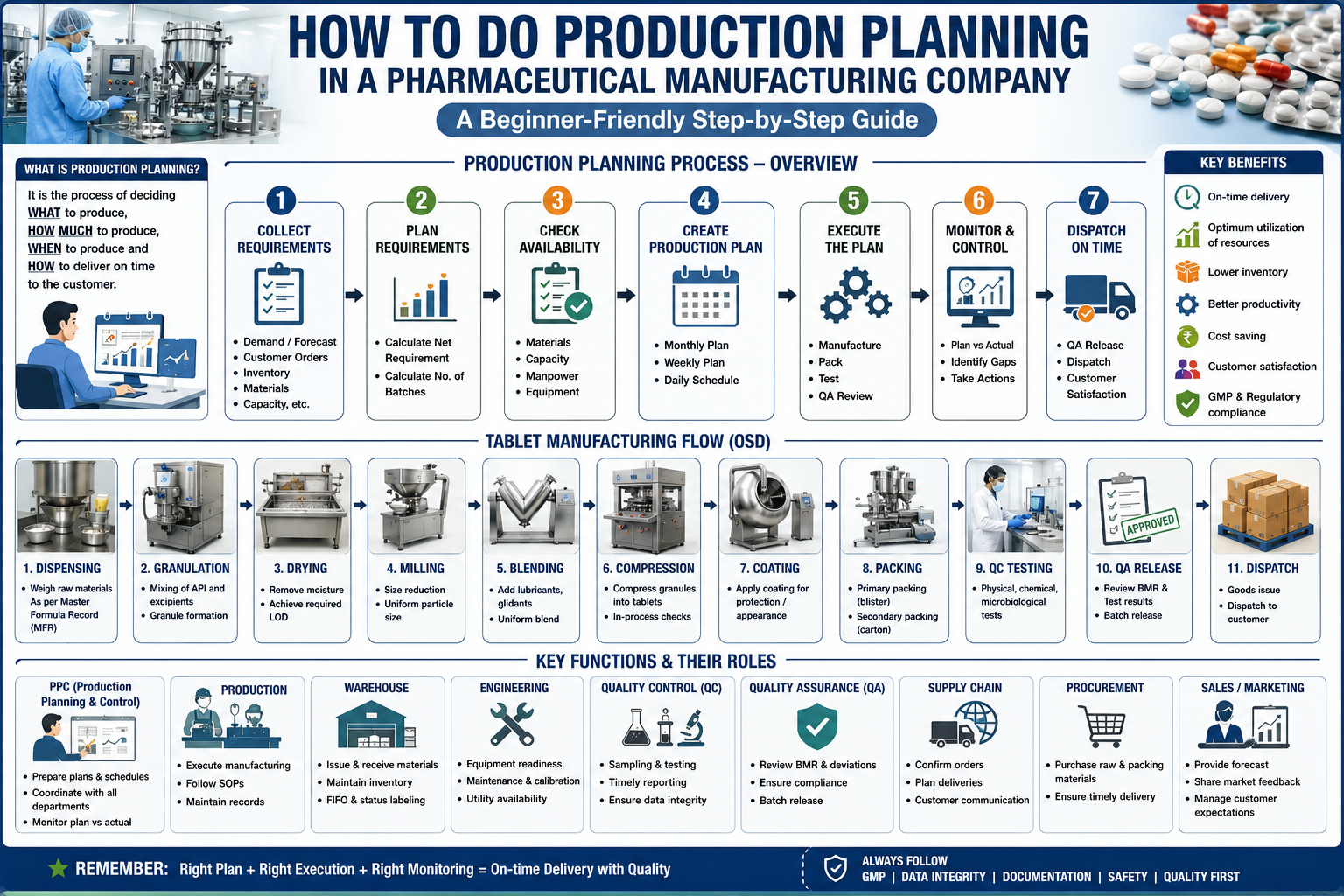

How to Do Production Planning in a Pharmaceutical Manufacturing Company

Production planning is one of the most important activities in a pharmaceutical manufacturing company.

A factory may have modern machines, trained employees, sufficient materials, and strong quality systems. But without proper production planning, the company may still face delayed batches, machine overload, material shortages, excess inventory, missed dispatches, and poor customer service.

This guide explains the complete pharmaceutical production planning process in simple language using an Oral Solid Dosage (OSD) tablet manufacturing plant as the main example.

The complete planning flow is:

Demand → Inventory Check → Net Requirement → Batch Calculation → Material Check → Capacity Check → Lead-Time Calculation → Prioritization → Monthly Plan → Weekly Plan → Daily Schedule → Execution → Monitoring → Recovery → QC Testing → QA Release → Dispatch


1. What Is Production Planning?

Imagine that you are preparing food for a wedding.

You expect 1,000 guests.

Before starting cooking, you need to know:

How many guests will attend?

How much food is required?

What ingredients are available?

How many cooks are available?

How many cooking vessels are available?

How much time is required?

When should cooking start?

Which dishes should be prepared first?

The same logic applies to pharmaceutical production.

Suppose a company must supply 10 million tablets during July.

The production planner must determine:

How many tablets are already available?

How many tablets must be manufactured?

How many batches are required?

Are raw materials available?

Are packing materials available?

Which machines will manufacture the batches?

How many hours are available?

When should manufacturing start?

When should packing finish?

How much time will QC testing require?

When can QA release the batches?

Will the products be ready before the customer delivery date?

Production planning means deciding what to manufacture, how much to manufacture, where to manufacture it, when to manufacture it, and when it must be completed.

Important Planning Terms

TermSimple MeaningExample
DemandQuantity required by the market10 million tablets
ForecastExpected future demandSales expects 12 million tablets next month
Customer OrderConfirmed requirementCustomer orders 5 million tablets
Production TargetQuantity the factory must produceManufacture 9 million tablets
Production PlanOverall plan for achieving the targetManufacture 18 batches during July
Production ScheduleExact timing of production activitiesBatch 001 on Granulator-1 Monday at 8:00 AM
Production ExecutionActual manufacturing activitiesOperators manufacture the batch
Dispatch PlanPlan for shipping released productsDispatch 3 million tablets on 25 July

A simple rule is:

Forecast tells us what may be required.

Demand tells us what is required.

The production plan tells us how the factory will manufacture it.

The production schedule tells us exactly when and where it will happen.


2. Information Required Before Making a Production Plan

A production planner should never start planning with only the sales demand.

A realistic plan requires information from Sales, Supply Chain, Warehouse, Procurement, Production, Engineering, QC, and QA.

2.1 Monthly Sales Forecast

The forecast estimates future market requirements.

Example:

Product A forecast = 10 million tablets.

Product B forecast = 5 million tablets.

The forecast helps the company purchase materials and reserve manufacturing capacity.

2.2 Confirmed Customer Orders

Confirmed orders normally receive greater attention because the company has committed to delivering the product.

Example:

Forecast = 10 million tablets.

Confirmed orders = 8 million tablets.

The planner must ensure the confirmed orders are protected while considering forecast demand and inventory policy.

2.3 Delivery Dates

Every order has a required delivery date.

If Product A must be dispatched on 15 July and Product B on 30 July, Product A will normally receive higher priority, assuming all other requirements are ready.

2.4 Finished Goods Inventory

These are manufactured, packed, and released products available for supply.

If demand is 10 million tablets and 2 million released tablets are available, the planner does not need to manufacture the entire 10 million.

2.5 Work-in-Progress Inventory

Work-in-progress, or WIP, means material that has started manufacturing but is not yet a released finished product.

Examples include:

Granules awaiting compression.

Compressed tablets awaiting coating.

Coated tablets awaiting packing.

Packed batches awaiting QC results or QA release.

The planner must consider usable WIP to avoid unnecessary production.

2.6 Raw Materials

The planner checks whether API and excipients are available.

API means Active Pharmaceutical Ingredient.

It is the ingredient responsible for the medicine’s therapeutic effect.

Excipients are other ingredients used to manufacture the tablet.

2.7 Packing Materials

These include:

Primary packing materials such as PVC, PVDC, aluminium foil, bottles, and caps.

Secondary packing materials such as cartons, labels, leaflets, and shippers.

A batch cannot be dispatched simply because manufacturing is complete. It must also be packed.

2.8 Material Lead Time

Lead time is the time between ordering material and having approved material available for production.

Suppose an API requires:

45 days for supplier manufacturing and delivery.

5 days for QC testing.

The effective material lead time is approximately 50 days.

The planner must consider this before committing production dates.

2.9 Batch Size

A batch is a defined quantity manufactured under one batch manufacturing record.

Example:

Batch size = 500,000 tablets.

Demand = 5 million tablets.

Required batches = 10.

2.10 Manufacturing Cycle Time

Cycle time is the time required to complete an operation or manufacturing stage.

Examples:

Granulation = 8 hours.

Compression = 16 hours.

Coating = 10 hours.

Packing = 24 hours.

The planner uses these times to calculate machine loading.

2.11 Equipment Availability

A machine may exist but may not be available.

Reasons include:

Preventive maintenance.

Breakdown.

Qualification.

Calibration.

Cleaning.

Product changeover.

Validation batches.

Therefore:

Installed capacity is not the same as available capacity.

2.12 Manpower Availability

Machines require trained and qualified employees.

A company may have sufficient machines but insufficient operators, technicians, or inspectors.

The production planner must therefore check shift-wise manpower availability.

2.13 Preventive Maintenance

Engineering may schedule equipment maintenance.

These hours must be deducted from available production time.

2.14 Changeover and Cleaning Time

Changing from one product to another requires cleaning, line clearance, documentation, and equipment setup.

Frequent product changes can significantly reduce production capacity.

2.15 Campaign Manufacturing

Campaign manufacturing means producing several consecutive batches of the same product or product family.

Example:

Instead of:

A → B → A → C → A

Plan:

A → A → A → B → C

This can reduce changeovers and improve capacity utilization, provided GMP and contamination-control requirements are met.

2.16 QC Testing Time

Manufactured batches require laboratory testing.

Testing time must be included in the dispatch plan.

2.17 QA Release Time

After testing is complete, Quality Assurance reviews batch records, deviations, results, and other required documents before releasing the batch.

2.18 Regulatory and Market Priorities

Certain products may receive higher priority because of:

Government tenders.

Export commitments.

Product shortages.

Critical medicines.

Launch batches.

Regulatory commitments.

The production planner must know these priorities.


3. Convert Demand into Production Requirements

Consider the following example.

Monthly demand = 10 million tablets.

Finished goods inventory = 2 million tablets.

Required safety stock = 1 million tablets.

The formula is:

Net Production Requirement = Demand + Safety Stock − Available Finished Goods Inventory

Therefore:

10 + 1 − 2 = 9 million tablets.

The factory must manufacture 9 million tablets.

Now calculate batches.

Batch size = 500,000 tablets.

Required quantity = 9,000,000 tablets.

Required Batches = Net Production Requirement ÷ Batch Size

9,000,000 ÷ 500,000 = 18 batches.

Therefore, the production planner must plan 18 batches.

What If the Number Is Not Exactly Divisible?

Suppose:

Net requirement = 9.2 million tablets.

Batch size = 500,000 tablets.

9,200,000 ÷ 500,000 = 18.4 batches.

Normally, the planner cannot manufacture 0.4 of a validated commercial batch unless an approved variable batch-size strategy exists.

Therefore, the planner may need to plan 19 full batches.

Production quantity:

19 × 500,000 = 9.5 million tablets.

The additional 300,000 tablets contribute to inventory, subject to shelf-life, demand, working-capital, and inventory-policy considerations.


4. Check Material Availability

Calculating batches is not enough.

The planner must determine whether those batches can actually be manufactured.

Assume each batch requires:

API = 100 kg.

Excipient = 400 kg.

Coating material = 20 kg.

PVC = 250 kg.

Aluminium foil = 100 kg.

Cartons = 25,000 units.

For 18 batches:

API requirement = 1,800 kg.

Excipient requirement = 7,200 kg.

Coating material requirement = 360 kg.

The planner compares requirements against usable inventory.

MaterialRequiredAvailable Approved StockShortage
API1,800 kg1,500 kg300 kg
Excipient7,200 kg8,000 kgNone
Coating Material360 kg400 kgNone

The API shortage means three batches cannot currently be manufactured.

Material Status Is Important

Materials may be:

Under Test: QC testing is incomplete.

Approved: Material can be used.

Blocked: Material is temporarily prevented from use.

Rejected: Material cannot be used.

Expired: Material cannot be used unless handled through an approved GMP process where applicable.

The planner should not treat under-test, blocked, rejected, or expired material as freely available production stock.

The correct question is not:

“Is material physically present?”

The correct question is:

“Is sufficient approved and usable material available when production needs it?”


5. Calculate Available Production Capacity

Capacity means how much work the factory can perform during a given period.

Suppose one compression machine is available for 30 days.

The factory operates 24 hours per day.

Total calendar hours:

30 × 24 = 720 hours.

Now deduct:

Preventive maintenance = 24 hours.

Cleaning = 40 hours.

Changeovers = 32 hours.

Other planned downtime = 24 hours.

Available production hours:

720 − 24 − 40 − 32 − 24 = 600 hours.

Therefore:

Available Production Capacity = 600 machine-hours.

Important Capacity Terms

Design Capacity

Maximum theoretical output under ideal conditions.

Example:

Machine rated speed = 300,000 tablets/hour.

Available Capacity

Capacity remaining after planned unavailable time is deducted.

Effective Capacity

Realistically achievable output considering normal operational losses.

Utilization

Utilization % = Actual Output ÷ Design Capacity × 100

Example:

Actual output = 80 million tablets.

Design capacity = 100 million tablets.

Utilization = 80%.

Efficiency

Efficiency % = Actual Output ÷ Expected Output × 100

Expected output = 90 million tablets.

Actual output = 81 million tablets.

Efficiency = 90%.

OEE

OEE means Overall Equipment Effectiveness.

OEE = Availability × Performance × Quality

Suppose:

Availability = 90%.

Performance = 95%.

Quality = 98%.

OEE:

0.90 × 0.95 × 0.98 × 100 = 83.79%.

OEE helps identify losses related to downtime, operating speed, and quality.


6. Understand the Manufacturing Route

A typical tablet manufacturing route is:

Dispensing → Granulation → Drying → Milling → Blending → Compression → Coating → Packing → QC Testing → QA Release → Dispatch

Dispensing

Approved raw materials are weighed according to the Batch Manufacturing Record.

Granulation

Powders are converted into granules suitable for tablet manufacturing.

Drying

Moisture is removed to the required level.

Milling

Granules are passed through a mill to obtain the required particle-size distribution.

Blending

Granules are mixed with lubricants and other required ingredients.

Compression

The final blend is compressed into tablets.

Coating

Tablets are coated when required by the product process.

Packing

Tablets are packed into blisters, strips, bottles, or other approved packs.

QC Testing

Samples are tested against approved specifications.

QA Release

QA reviews the manufacturing, packing, testing, deviations, and associated records before batch disposition.

Dispatch

Released finished goods are shipped according to the dispatch plan.

A planner must understand this route because a delay at one stage affects every downstream activity.


7. Calculate Manufacturing Lead Time

Consider one batch.

ActivityProcessing/Waiting Time
Dispensing4 hours
Granulation8 hours
Drying6 hours
Milling2 hours
Blending4 hours
Compression16 hours
Coating10 hours
Packing24 hours
QC Testing72 hours
QA Release24 hours

Total theoretical lead time:

4 + 8 + 6 + 2 + 4 + 16 + 10 + 24 + 72 + 24 = 170 hours.

170 hours ÷ 24 = approximately 7.1 days.

In reality, queue time, sampling, material movement, weekends, laboratory workload, documentation corrections, equipment waiting, and shift patterns can increase total lead time.

Therefore, the planner should use realistic historical lead times rather than only theoretical processing time.

Backward Scheduling

Suppose the batch must be dispatched on 30 July.

QA release requires 1 day.

QC testing requires 3 days.

Packing requires 1 day.

Manufacturing requires 3 days.

The planner works backward.

Dispatch: 30 July.

QA release complete: 29 July.

QC testing complete: 28 July.

Packing complete: 25 July.

Manufacturing complete: 24 July.

Manufacturing must therefore start around 21 July, allowing additional safety time where appropriate.

This is called backward scheduling.


8. Prepare the Monthly Production Plan

Assume the following demand.

ProductDemand (Million Tablets)InventorySafety StockNet RequirementBatch Size (Million)Required BatchesPriorityCompletion Date
Product A102190.518High15 July
Product B610.55.50.511Medium22 July
Product C410.53.50.2514High18 July
Product D83161.06Low30 July
Product E50.50.550.510Medium25 July

The planner now checks:

Materials.

Manufacturing capacity.

Packing capacity.

Equipment compatibility.

Maintenance schedules.

QC capacity.

QA release requirements.

Delivery dates.

Product priorities.

The monthly plan should only contain quantities that are reasonably achievable.

An unrealistic target is not a production plan.

It is only a wish list.


9. Convert the Monthly Plan into a Weekly Plan

Suppose Product A requires 18 batches.

A possible weekly allocation is:

ProductWeek 1Week 2Week 3Week 4Total
Product A1080018
Product B245011
Product C770014
Product D01236
Product E024410

The planner must verify that weekly loading does not exceed available capacity.

For example, scheduling 25 compression batches in Week 1 is useless if compression capacity is only 15 batches.

The planner balances the load across departments.

This is called finite capacity planning when the plan respects actual available capacity.


10. Convert the Weekly Plan into a Daily Production Schedule

A daily schedule tells the shop floor exactly what should happen.

DateProductBatchStageEquipmentStartFinishCleaning/ChangeoverDepartmentStatus
1 JulyAA001GranulationRMG-0108:0016:002 hrsProductionPlanned
1 JulyCC001CompressionCT-0307:0023:003 hrsProductionIn Progress
2 JulyAA001CompressionCT-0106:0022:002 hrsProductionPlanned
2 JulyEE001CoatingCP-0208:0018:003 hrsProductionPlanned
3 JulyCC001PackingBP-0407:0007:00 Next Day4 hrsPackingPlanned

The supervisor uses the schedule to arrange:

Operators.

Equipment.

Documents.

Materials.

Cleaning.

Line clearance.

In-process testing.

Material movement.

The planner updates actual start and finish times to monitor schedule adherence.


11. Production Sequencing

Production sequencing means deciding the order in which products and batches should run.

The planner considers:

Delivery dates.

Market priority.

Material readiness.

Equipment compatibility.

Cleaning requirements.

Campaign opportunities.

Product potency.

Tablet color.

Cross-contamination risks.

Sensitizing materials.

Changeover requirements.

Poor Sequence

White Product A → Dark Red Product B → White Product A → Blue Product C → White Product A.

This creates repeated cleaning and changeovers.

Better Sequence

White Product A → White Product A → White Product A → Blue Product C → Dark Red Product B.

This may reduce cleaning and changeover time.

However, sequencing decisions must always comply with approved contamination-control strategies, cleaning validation requirements, product-specific restrictions, and GMP procedures.

Efficiency cannot override patient safety or GMP requirements.


12. Identify Bottlenecks

Imagine a highway.

Five lanes suddenly become one lane.

Traffic accumulates.

That narrow point is the bottleneck.

The same happens in manufacturing.

Suppose weekly capacities are:

Granulation = 30 batches.

Compression = 20 batches.

Coating = 25 batches.

Packing = 15 batches.

The factory cannot sustainably produce 30 finished batches per week because packing can only handle 15.

Packing is the bottleneck.

Theory of Constraints

The Theory of Constraints can be explained in five simple steps:

Identify the bottleneck.

Use the bottleneck as effectively as possible.

Organize other activities to support the bottleneck.

Increase bottleneck capacity when justified.

Repeat the process because the bottleneck may move.

The production planner should protect bottleneck equipment from avoidable waiting.


13. Prepare Capacity vs. Demand Analysis

DepartmentAvailable HoursRequired HoursLoading %SituationCorrective Action
Granulation60054090%AcceptableMonitor
Compression1,0001,150115%OverloadedAdd shift/resequence/use alternate machine
Coating50040080%Available CapacitySupport schedule flexibility
Packing9001,080120%OverloadedOvertime/alternate line/campaign planning
QC800920115%OverloadedPrioritize samples and rebalance resources

When demand exceeds capacity, possible actions include:

Reduce avoidable downtime.

Add shifts or approved overtime.

Use compatible alternate equipment.

Reduce unnecessary changeovers.

Improve campaign planning.

Subcontract activities where legally and technically approved.

Negotiate delivery priorities.

Increase capacity through long-term investment.

The planner should not simply load more work onto an already overloaded department.


14. Create a Production Planning Excel Workbook

A beginner can start with a simple workbook.

Sheet 1: Demand Plan

Suggested columns:

Product.

Forecast.

Confirmed Orders.

Delivery Date.

Priority.

Sheet 2: Inventory Status

Product.

Released Finished Goods.

WIP.

Safety Stock.

Usable Inventory.

Sheet 3: Material Availability

Product.

Material Code.

Material Description.

Required Quantity.

Approved Stock.

Under-Test Stock.

Expected Release Date.

Purchase Order Quantity.

Expected Delivery Date.

Shortage.

Sheet 4: Batch Requirement Calculator

Product.

Net Requirement.

Batch Size.

Required Batches.

Simple Excel formula:

=ROUNDUP(Net_Requirement/Batch_Size,0)

Sheet 5: Equipment Capacity

Equipment.

Calendar Hours.

Maintenance Hours.

Cleaning Hours.

Changeover Hours.

Other Downtime.

Available Hours.

Formula:

=Calendar_Hours-Maintenance_Hours-Cleaning_Hours-Changeover_Hours-Other_Downtime

Sheet 6: Monthly Production Plan

Product.

Required Batches.

Material Status.

Capacity Status.

Priority.

Required Completion Date.

Planned Month.

Sheet 7: Weekly Production Plan

Product.

Week 1.

Week 2.

Week 3.

Week 4.

Total Planned.

Sheet 8: Daily Production Schedule

Date.

Product.

Batch.

Stage.

Equipment.

Planned Start.

Planned Finish.

Actual Start.

Actual Finish.

Delay.

Reason.

Status.

Sheet 9: Production Tracking

Date.

Product.

Planned Quantity.

Actual Quantity.

Variance.

Plan Attainment.

Delay Reason.

Corrective Action.

Owner.

Target Date.

Sheet 10: Plan vs. Actual Dashboard

Recommended KPIs:

Production Plan Attainment.

Schedule Adherence.

Capacity Utilization.

OEE.

OTIF.

Yield.

RFT.

Delayed Batches.

Material Shortages.

Pending QC Samples.

Pending QA Releases.


15. Production Plan Execution

After approval, the plan moves to execution.

PPC

Prepares and communicates the plan.

Coordinates departments.

Tracks progress.

Identifies delays.

Coordinates recovery plans.

Production

Arranges manpower.

Verifies equipment readiness.

Executes manufacturing.

Completes GMP documentation.

Performs in-process controls.

Warehouse

Maintains material availability.

Ensures correct material status.

Dispenses and issues approved materials.

Controls storage and material movement.

Procurement

Places purchase orders.

Follows suppliers.

Expedites critical materials.

Manages supplier delivery commitments.

Engineering

Maintains equipment and utilities.

Performs preventive maintenance.

Responds to breakdowns.

Coordinates technical availability.

QC

Samples and tests materials and products.

Communicates testing status.

Supports investigation of out-of-specification results when required.

QA

Provides line clearance where applicable.

Reviews GMP documentation.

Manages deviations and quality-system requirements.

Reviews batch records.

Performs batch disposition and release according to procedures.

Supply Chain

Balances demand, inventory, supply, and customer commitments.

Coordinates dispatch priorities.

The plan succeeds only when these departments work as one system.


16. Daily Production Review Meeting

A short, disciplined 15-minute review meeting can significantly improve execution.

Suggested Agenda

Minutes 1–3: Yesterday’s Plan vs. Actual

What was planned?

What was completed?

What was delayed?

Minutes 4–6: Today’s Target

What batches must be manufactured?

What must be packed?

What critical activities are planned?

Minutes 7–10: Constraints

Material shortages.

Equipment breakdowns.

Manpower shortages.

Quality issues.

QC pending samples.

QA pending releases.

Minutes 11–13: Recovery Actions

What must be done?

Who owns the action?

When will it be completed?

Minutes 14–15: Escalations

Which issues require management support?

The meeting should end with:

Problem → Action → Owner → Deadline


17. Plan vs. Actual Production Tracking

Production Plan Attainment

Plan Attainment % = Actual Production ÷ Planned Production × 100

Plan = 100 batches.

Actual = 92 batches.

Attainment = 92%.

Schedule Adherence

A simple batch-based calculation is:

Schedule Adherence % = Activities Completed On Schedule ÷ Total Scheduled Activities × 100

90 activities were scheduled.

81 finished on time.

Schedule adherence = 90%.

Capacity Utilization

Capacity Utilization % = Actual Operating Hours ÷ Available Production Hours × 100

Available hours = 600.

Operating hours = 510.

Utilization = 85%.

OEE

OEE = Availability × Performance × Quality

Availability = 90%.

Performance = 95%.

Quality = 98%.

OEE = 83.79%.

OTIF

OTIF means On-Time In-Full.

OTIF % = Orders Delivered On Time and In Full ÷ Total Orders × 100

100 orders.

93 delivered on time and in full.

OTIF = 93%.

Yield

Yield % = Actual Acceptable Output ÷ Theoretical Output × 100

Theoretical output = 1,000 kg.

Acceptable output = 970 kg.

Yield = 97%.

Right First Time

RFT means Right First Time.

A practical calculation is:

RFT % = Batches Completed Without Rework, Reprocessing, or Correctable Execution Error ÷ Total Batches × 100

95 batches meet the approved RFT definition.

100 batches were produced.

RFT = 95%.

Companies should define KPI formulas consistently in approved procedures because definitions can differ between organizations.


18. What to Do When the Production Plan Fails

Plans will not always run exactly as expected.

The planner needs a structured recovery process.

Raw Material Unavailable

Check alternate approved lots.

Expedite procurement.

Reschedule another material-ready product.

Review inventory allocation.

Escalate customer risk.

Packing Material Delayed

Complete bulk manufacturing only if hold-time limits, storage capacity, demand risk, and procedures allow.

Reschedule packing lines.

Expedite suppliers.

Prioritize critical markets.

Equipment Breakdown

Estimate repair duration.

Check alternate qualified equipment.

Resequence production.

Protect bottleneck operations.

Evaluate approved overtime or additional shifts.

Manpower Shortage

Reallocate trained employees.

Adjust shift patterns.

Use approved overtime.

Prioritize critical products.

Batch Failure or Rejection

Immediately assess supply impact.

Do not assume rejected quantity can simply be replaced.

Check materials and capacity for replacement production.

Coordinate with QA and Supply Chain.

QC Testing Delay

Prioritize samples according to dispatch risk.

Review laboratory workload.

Escalate critical testing constraints.

Improve sample scheduling.

QA Release Delay

Identify missing records, deviations, investigations, or review bottlenecks.

Prioritize batches according to dispatch requirements without compromising quality decisions.

Urgent Customer Order

Check inventory first.

Check WIP.

Check materials.

Check capacity.

Evaluate impact on existing commitments.

Obtain approval before changing the frozen schedule.

Simple Recovery Flowchart

Problem Detected

Does the problem affect safety, quality, or GMP compliance?

→ Yes: Stop or control the affected activity and involve QA according to procedure.

→ No: Continue operational assessment.

Identify affected batches and customer orders

Determine the root constraint

Check material, equipment, manpower, QC, QA, and logistics options

Create alternative production scenarios

Evaluate impact on existing commitments

Approve revised plan

Communicate the new schedule

Execute recovery actions

Monitor until normal operation is restored


19. End-to-End Practical Case Study

Consider a tablet manufacturing facility producing five products.

ProductDemand (M Tablets)FG InventorySafety StockBatch Size (M)Net RequirementBatches
Alpha12210.51122
Beta8210.5714
Gamma610.50.255.522
Delta10311.088
Epsilon510.50.54.59

Total required batches = 75.

Material Status

Alpha: All materials available.

Beta: API for four batches delayed until 10 July.

Gamma: All materials available.

Delta: Packing materials delayed until 15 July.

Epsilon: All materials available.

Equipment Capacity

Granulation available capacity = 80 batches.

Compression available capacity = 70 batch-equivalents.

Coating available capacity = 60 coated batches.

Packing available capacity = 65 batch-equivalents.

The exact comparison must use machine-hours or standardized units because batch durations differ.

For simplicity, assume the loading analysis shows:

Granulation = 85%.

Compression = 110%.

Coating = 90%.

Packing = 115%.

Therefore, compression and packing are constraints.

Manufacturing Times Per Batch

ProductGranulationCompressionCoatingPackingQCQA Release
Alpha8 hrs16 hrs10 hrs20 hrs72 hrs24 hrs
Beta10 hrs18 hrs12 hrs24 hrs72 hrs24 hrs
Gamma6 hrs10 hrs8 hrs16 hrs48 hrs24 hrs
Delta12 hrs24 hrs16 hrs30 hrs96 hrs24 hrs
Epsilon8 hrs14 hrs10 hrs18 hrs72 hrs24 hrs

Delivery Dates

Alpha = 15 July.

Gamma = 18 July.

Beta = 22 July.

Epsilon = 25 July.

Delta = 30 July.

Maintenance Schedule

Compression Machine CT-02 unavailable from 8–10 July.

Packing Line BP-03 unavailable on 12 July.

Step 1: Calculate Net Requirements

Demand + Safety Stock − Finished Goods Inventory.

This determines the quantities requiring production.

Step 2: Convert Quantities into Batches

Round up when full validated batch sizes must be manufactured.

Step 3: Check Materials

Alpha, Gamma, and Epsilon are ready.

Part of Beta is delayed.

Delta cannot be packed before 15 July because packing material is unavailable.

Step 4: Check Capacity

Compression and packing are overloaded.

These departments require careful scheduling.

Step 5: Prioritize Products

A practical initial priority is:

Alpha.

Gamma.

Available Beta batches.

Epsilon.

Delta.

However, the planner must also consider existing WIP, campaign opportunities, equipment compatibility, and exact dispatch quantities.

Step 6: Sequence Production

Run consecutive batches where possible.

Avoid unnecessary product changes.

Schedule products requiring unavailable materials later.

Protect compression capacity during the CT-02 maintenance shutdown.

Avoid loading BP-03 immediately before its maintenance window if doing so creates stranded WIP.

Step 7: Monthly Plan

Approve only quantities supported by materials and finite capacity.

Flag Beta and Delta supply risks.

Create a recovery plan for compression and packing overload.

Step 8: Weekly Plan

Week 1:

Focus on Alpha and Gamma.

Start available Beta batches.

Week 2:

Complete Alpha and Gamma.

Resume Beta after material arrival.

Begin Epsilon.

Week 3:

Complete Beta and Epsilon.

Begin Delta packing after materials become available.

Week 4:

Complete Delta.

Use remaining capacity for recovery and approved inventory requirements.

Step 9: Daily Schedule

Create equipment-wise schedules.

Example:

CT-01: Alpha campaign.

CT-02: Gamma before maintenance, then Beta after maintenance.

CT-03: Gamma and Epsilon according to due dates.

Packing lines are scheduled according to downstream QC and dispatch priorities.

Step 10: Track Production

Every day compare:

Planned start vs. actual start.

Planned finish vs. actual finish.

Planned quantity vs. actual quantity.

Delay hours.

Delay reasons.

Recovery actions.

Step 11: Handle a Delay

Suppose CT-01 breaks down for 12 hours.

The planner:

Confirms estimated repair time.

Checks whether Alpha can run on another qualified machine.

Evaluates moving compatible batches.

Protects the 15 July Alpha commitment.

Updates the packing schedule.

Informs QC of revised sample arrival.

Updates QA and Supply Chain.

Creates a revised finite-capacity schedule.

Step 12: Create Recovery Plan

Possible actions:

Move qualified Alpha batches to CT-03.

Run Gamma after Alpha if due-date protection requires it.

Use approved overtime on packing lines.

Reduce unnecessary changeovers.

Prioritize QC testing based on dispatch risk.

Reserve QA review capacity for critical batches.

Step 13: Ensure On-Time Dispatch

The planner creates a dispatch readiness board containing:

Product.

Order quantity.

Finished goods available.

Manufacturing status.

Packing status.

QC status.

QA release status.

Dispatch date.

Risk.

Action owner.

This connects production activity directly to customer delivery.


20. Beginner’s Production Planning Checklist

Before finalizing the plan, check the following:

  • Demand and confirmed orders reviewed.
  • Delivery dates confirmed.
  • Finished goods inventory checked.
  • WIP checked.
  • Safety stock requirements considered.
  • Batch requirements calculated correctly.
  • Approved raw materials available.
  • Packing materials available.
  • Material release dates confirmed.
  • Equipment compatibility checked.
  • Equipment capacity calculated.
  • Maintenance schedule included.
  • Cleaning time included.
  • Changeover time included.
  • Manpower availability checked.
  • Manufacturing lead times considered.
  • QC testing capacity checked.
  • QA release time considered.
  • Campaign opportunities evaluated.
  • Cross-contamination controls respected.
  • Bottleneck equipment identified.
  • Monthly plan checked against finite capacity.
  • Weekly loading balanced.
  • Daily schedule prepared.
  • Production priorities communicated.
  • Plan vs. actual tracking established.
  • Recovery actions defined for major risks.
  • Dispatch dates protected.
  • GMP requirements maintained.
  • Plan approved and communicated.

21. Common Production Planning Mistakes

  1. Planning directly from gross demand.

Always check inventory, WIP, and safety stock first.

  1. Ignoring material status.

Physical stock does not always mean usable stock.

  1. Using theoretical machine capacity.

Deduct maintenance, cleaning, changeovers, and realistic downtime.

  1. Ignoring QC testing time.

Manufacturing completion is not dispatch readiness.

  1. Ignoring QA release time.

A packed batch cannot be dispatched until appropriately released.

  1. Overloading bottleneck equipment.

The result is excess WIP and delayed orders.

  1. Too many product changeovers.

Poor sequencing wastes capacity.

  1. Ignoring preventive maintenance.

The schedule becomes unrealistic.

  1. Planning without manpower checks.

Available machines still require trained employees.

  1. Changing the schedule too frequently.

Constant schedule changes create confusion and instability.

  1. Not freezing the short-term schedule.

A reasonable frozen planning window improves execution discipline.

  1. Ignoring existing WIP.

This can create unnecessary production and excess inventory.

  1. Failing to connect production to dispatch dates.

The purpose of planning is reliable supply, not simply machine utilization.

  1. Ignoring QC and QA capacity.

Laboratory and release backlogs can become major supply constraints.

  1. No recovery plan.

Every critical production plan should identify major risks and alternatives.

  1. Using inconsistent master data.

Incorrect batch sizes, cycle times, yields, or routing data create incorrect plans.

  1. Optimizing one department only.

Maximum granulation output is useless if compression or packing cannot process the WIP.

  1. Ignoring GMP for productivity.

Production targets never justify bypassing procedures, line clearance, cleaning, documentation, data integrity, or quality decisions.


22. Ten Golden Rules of Pharmaceutical Production Planning

Rule 1: Start with demand, but always subtract usable inventory and WIP.

Rule 2: Never schedule a batch without checking approved material availability.

Rule 3: Plan using realistic available capacity, not theoretical capacity.

Rule 4: Identify and protect the bottleneck.

Rule 5: Include cleaning, changeovers, maintenance, QC testing, and QA release in the schedule.

Rule 6: Sequence products intelligently, but never compromise GMP or contamination control.

Rule 7: Convert the monthly plan into weekly and daily executable schedules.

Rule 8: Measure plan vs. actual every day and act quickly on deviations.

Rule 9: Every delay must have an action, owner, and target completion time.

Rule 10: A production plan is successful only when the correct product is manufactured, tested, released, and delivered on time, in full, and in compliance with GMP requirements.

Conclusion

Pharmaceutical production planning is not simply preparing an Excel sheet containing batch numbers.

It is the process of connecting customer demand with inventory, materials, people, machines, manufacturing capacity, quality testing, batch release, and dispatch commitments.

A beginner should remember the complete planning logic:

Understand Demand

Check Inventory and WIP

Calculate Net Requirements

Convert Requirements into Batches

Check Approved Materials

Calculate Available Capacity

Calculate Manufacturing and Release Lead Times

Identify Bottlenecks

Prioritize and Sequence Products

Prepare Monthly Production Plan

Convert Monthly Plan into Weekly Plan

Convert Weekly Plan into Daily Schedule

Execute Under GMP Controls

Track Plan vs. Actual

Identify Delays and Constraints

Create and Execute Recovery Actions

Complete QC Testing and QA Release

Dispatch the Correct Product On Time and In Full

The most important lesson is simple:

A good production plan must be realistic, capacity-feasible, material-feasible, quality-compliant, time-bound, measurable, and directly connected to customer delivery.

Leave a Comment

Scroll to Top
