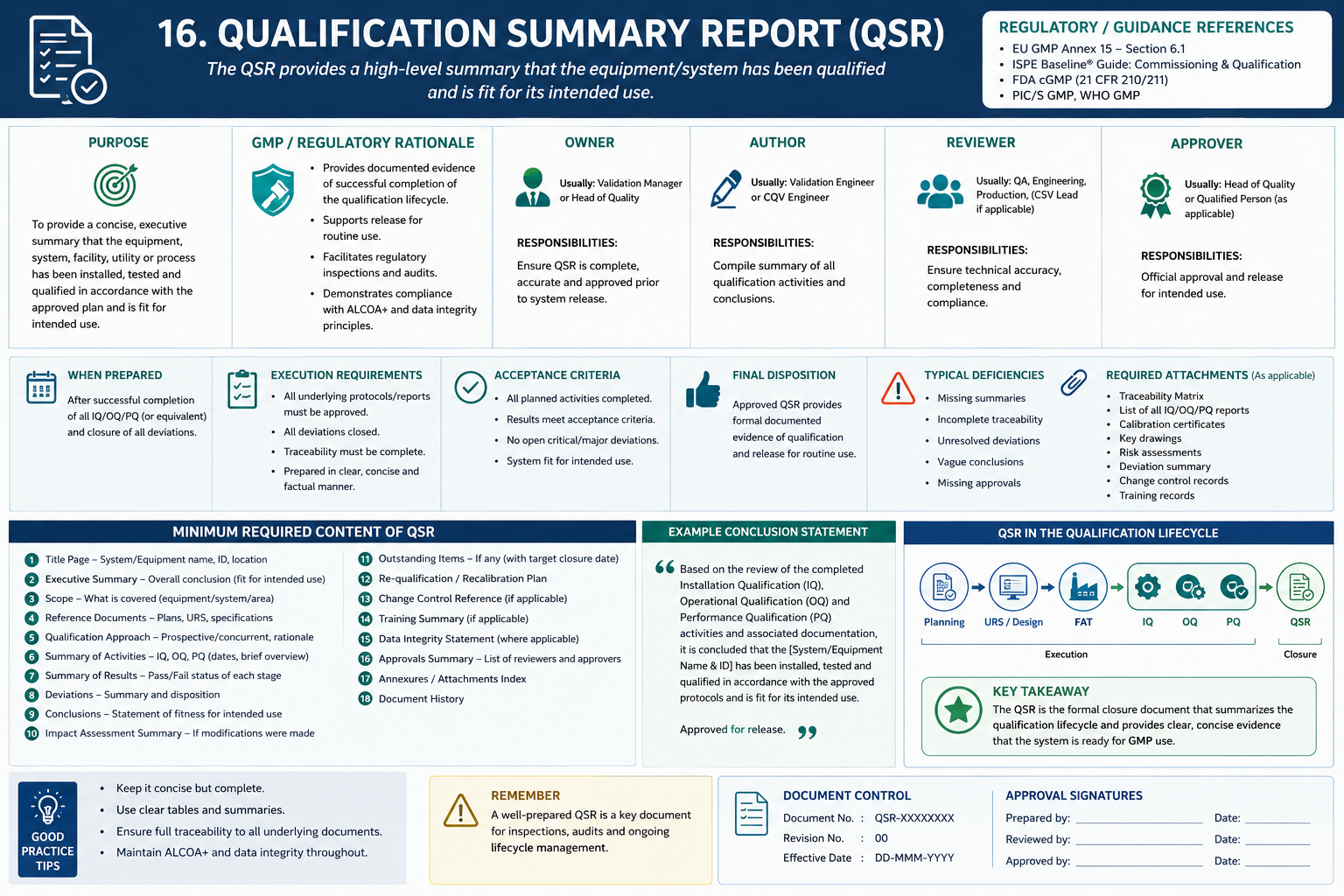

How to Prepare a Qualification Summary Report (QSR) in Pharma.

Part 16

The Qualification Summary Report (QSR) is the principal lifecycle-closure document used to consolidate, assess, and conclude whether qualification evidence supports the intended qualified state of a facility, utility, equipment, or system.

The Part 16 will cover:

Objective → Scope → Equipment/System → Protocols Executed → Test Summary → Deviations → Open Items → CAPAs → Change Controls → Acceptance-Criteria Status → Traceability Status → Outstanding Risks → Restrictions/Limitations → Conclusion → Recommended Qualified State → QA Disposition → Release for GMP Use where applicable.

It also requires a critical distinction:

Successful protocol execution alone does not automatically mean the system is suitable for GMP use.


16.1 What Is a Qualification Summary Report?

A Qualification Summary Report is a controlled document that consolidates and evaluates the completed qualification lifecycle and provides a documented conclusion regarding qualification status.

It should answer the central question:

Does the totality of qualification evidence demonstrate that the equipment/system is fit for its defined intended use, subject to any documented restrictions or outstanding actions?

The QSR therefore goes beyond simply reporting that IQ, OQ, and PQ were executed.


16.2 Position of the QSR in the Qualification Lifecycle

Your source places the QSR near the end of the qualification lifecycle:

Business / Process Need
        ↓
System Definition
        ↓
URS
        ↓
GMP / System Impact Assessment
        ↓
Quality Risk Assessment
        ↓
Design & DQ
        ↓
Supplier Assessment
        ↓
FAT
        ↓
Installation
        ↓
SAT / Commissioning
        ↓
IQ
        ↓
OQ
        ↓
PQ
        ↓
Traceability Review
        ↓
Deviation / Punch-List Closure
        ↓
QUALIFICATION SUMMARY REPORT
        ↓
SOP + Training Readiness
        ↓
QA / GMP Release
        ↓
Routine Operation

This sequence is explicitly reflected in the complete qualification workflow required by the master source.


16.3 QSR Is More Than a Protocol Summary

A weak report may state:

IQ — Passed
OQ — Passed
PQ — Passed
Equipment Qualified.

This is insufficient as a comprehensive lifecycle assessment.

A stronger QSR asks:

  • Were all required qualification activities completed?
  • Were applicable requirements tested?
  • Were predefined acceptance criteria met?
  • Were deviations adequately investigated?
  • Were retests justified?
  • Were changes controlled?
  • Are critical risks adequately controlled?
  • Is traceability complete?
  • Are open items acceptable?
  • Are restrictions required?
  • Are SOPs and training ready for GMP operation?
  • Is the system actually suitable for its intended GMP use?

16.4 Fundamental QSR Evidence Model

URS / Intended Use
       +
Risk Assessment
       +
DQ
       +
FAT / SAT
       +
IQ / OQ / PQ
       +
Raw Data
       +
Deviations / Retests
       +
Change Controls
       +
Traceability
       +
Residual Risk
       +
Operational Readiness
       ↓
QUALIFICATION SUMMARY REPORT
       ↓
Qualification Recommendation
       ↓
QA Disposition
       ↓
GMP Release where applicable

This aligns with the master source’s critical qualification principle:

Intended Use → Requirements → Risks → Design → Critical Aspects → Verification/Testing → Deviations → Traceability → Qualified State → Lifecycle Control.


16.5 Purpose of the QSR

The QSR should provide a concise but complete assessment of the qualification program.

Its functions include:

Consolidation

Bring together qualification evidence generated across multiple lifecycle documents.

Assessment

Evaluate whether the evidence collectively supports the intended qualified state.

Exception Review

Evaluate deviations, failures, open items, CAPAs and changes.

Traceability Confirmation

Confirm that applicable requirements have been addressed.

Risk Review

Evaluate outstanding/residual qualification risks.

Qualification Recommendation

Recommend an appropriate qualification status.

Release Support

Support QA/GMP release where applicable.


16.6 Recommended QSR Structure

A practical structure based on the source is:

SectionContent
1Document Control
2Objective
3Scope
4Equipment/System Identification
5Background/Intended Use
6Qualification Strategy
7Documents/Protocols Executed
8Test Summary
9Acceptance-Criteria Status
10Deviations/Discrepancies
11Retesting
12Open Items/Punch List
13CAPA
14Change Controls
15Traceability Status
16Outstanding/Residual Risks
17SOP/Training Readiness
18Restrictions/Limitations
19Overall Assessment
20Conclusion
21Recommended Qualified State
22QA Disposition
23GMP Release where applicable
24Approvals
25Attachments

The source specifically requires the major elements listed in Part 16; the expanded organization above is a practical handbook structure rather than a source-prescribed mandatory format.


16.7 Document Control

The report should be uniquely identifiable.

Typical fields may include:

FieldExample
Document TitleQualification Summary Report
EquipmentTablet Compression Machine
Equipment IDTCM-01
Document No.QSR-TCM-001
Revision00
DepartmentProduction
LocationCompression Room ___
Project______

Document numbering and revision conventions should follow the company’s PQS.


16.8 Objective

The objective should state what the QSR is intended to conclude.

Example

The objective of this Qualification Summary Report is to summarize and assess the qualification activities performed for the identified tablet compression machine and determine whether the available documented evidence supports the recommended qualified state for its defined intended use.

The objective should not predetermine the conclusion.


16.9 Scope

Define exactly what the report covers.

Potentially include:

  • equipment/system;
  • subsystems;
  • qualification stages;
  • computerized functions;
  • utilities;
  • interfaces;
  • applicable project/change.

Also define exclusions where necessary.


16.10 Example Scope

This report summarizes the qualification lifecycle for Tablet Compression Machine TCM-01, including applicable DQ, FAT, SAT, IQ, OQ and PQ activities, associated deviations, change controls, traceability and qualification closure status.

Where a related system is qualified separately, identify that boundary.

For example:

The facility HVAC system is qualified under a separate qualification package and is outside the direct scope of this report.


16.11 Equipment/System Identification

The QSR should clearly identify the asset being assessed.

Recommended fields:

ItemDetails
Equipment/System Name______
Equipment ID______
Manufacturer______
Model______
Serial Number______
Location______
Department______
Software Version______ where applicable
PLC/HMI Version______ where applicable
Configuration Version______ where applicable

This prevents ambiguity about what qualified configuration the conclusion applies to.


16.12 Intended Use

The QSR should remain linked to intended use.

Qualification is not simply:

“The machine works.”

The question is:

Does the machine work appropriately for its defined intended GMP use?

For example, the intended use of a tablet compression machine may define the relevant:

  • manufacturing operation;
  • operating range;
  • product-contact arrangement;
  • automation functions;
  • control strategy;
  • GMP data functions.

The exact intended use should be taken from the approved project documentation.


16.13 Qualification Strategy Summary

Briefly summarize the qualification strategy applied.

For example:

Qualification was performed using a lifecycle and risk-based approach incorporating approved requirements, impact/risk assessment, design verification, supplier/site testing and IQ/OQ/PQ verification as applicable.

Where supplier evidence was leveraged, the QSR should make this visible rather than implying every test was repeated at site.


16.14 Protocols Executed

Your source specifically requires the QSR to identify the protocols executed.

A useful table is:

No.DocumentDocument No.RevisionExecution Status
1DQDQ-TCM-00100Complete
2FATFAT-TCM-00100Complete
3SATSAT-TCM-00100Complete
4IQIQ-TCM-00100Complete
5OQOQ-TCM-00100Complete
6PQPQ-TCM-00100Complete

Only lifecycle documents actually applicable to the system should be listed.


16.15 Document Status

For each document, consider whether it is:

  • approved;
  • executed;
  • reviewed;
  • complete;
  • superseded;
  • open;
  • not applicable.

A protocol being “executed” does not necessarily mean all associated issues are closed.


16.16 Test Summary

The QSR should provide an overview of qualification testing.

Example:

Qualification StagePlanned TestsExecutedPassed InitiallyFailed InitiallyRetestedFinal Acceptable
IQ2525241125
OQ4242393342
PQ666006

This is more transparent than simply writing:

IQ/OQ/PQ = PASS.


16.17 Do Not Hide Initial Failures

Suppose:

OQ Test 17 — Initial Fail
DEV-014 raised
Correction completed
OQ Test 17-R1 — Pass

The QSR should reflect this history.

Do not summarize:

“OQ-17 Passed.”

without appropriate visibility of the associated deviation/retest.

Part 14 and Part 15 of the source explicitly emphasize retaining failed results and controlling retesting.


16.18 Acceptance-Criteria Status

The source specifically requires the QSR to evaluate acceptance-criteria status.

The report should determine whether applicable predefined criteria were:

  • met initially;
  • met after justified corrective action/retest;
  • not met;
  • not applicable with justification;
  • unresolved.

16.19 Acceptance-Criteria Summary

StatusNumber
Criteria met initially___
Criteria met after retest___
N/A with justification___
Open___
Not met___

The report should explain significant exceptions.


16.20 Why “All Tests Completed” Is Not Enough

A test can be completed and still fail.

Therefore:

Execution completion ≠ Acceptance

The QSR should distinguish between:

  • test executed;
  • result reviewed;
  • acceptance criterion met;
  • deviation resolved;
  • requirement verified.

16.21 Deviations

Your source explicitly requires deviations to be summarized in the QSR.

A practical deviation table:

DeviationProtocol/TestDescriptionImpactAction/RetestFinal Status
DEV-001IQ-012_________Closed
DEV-002OQ-017______OQ-017-R1Closed
DEV-003PQ-004_________Open/Closed

16.22 Deviation Summary Should Be Meaningful

Avoid:

Three deviations occurred. All closed.

Instead summarize:

  • what failed;
  • why it mattered;
  • what investigation concluded;
  • what action was taken;
  • whether retesting occurred;
  • whether residual qualification impact remains.

The detailed investigation remains in the deviation record; the QSR provides the lifecycle-level assessment.


16.23 Retest Summary

Where retesting occurred, summarize:

Original Test → Failure → Deviation → Correction → Retest → Result

Example:

Original TestDeviationCause/DispositionRetestFinal
OQ-017DEV-014Controlled correctionOQ-017-R1Pass

This demonstrates that qualification was not simply repeated until a passing result appeared.


16.24 Open Items

Your source specifically requires open items to be addressed.

Examples might include:

  • punch-list items;
  • documentation actions;
  • minor engineering items;
  • outstanding CAPAs;
  • pending procedural actions.

Every open item should be evaluated for its effect on qualification and release.


16.25 Open-Item Assessment

ItemDescriptionGMP ImpactQualification ImpactDue Date/OwnerRelease Impact
OI-001___None/Low/etc._________
OI-002_______________

Do not allow an open-item list to become a parking area for unresolved critical failures.


16.26 Critical vs Noncritical Open Items

Consider two examples.

Example A

Cosmetic external-panel label replacement pending.

Potentially low qualification impact if equipment identity and GMP operation remain unaffected.

Example B

Automatic reject mechanism not fully verified.

Potentially significant because a critical functional requirement remains unresolved.

The QSR should distinguish these situations.


16.27 CAPAs

The source requires CAPAs to be summarized.

A CAPA may arise from:

  • significant qualification deviation;
  • repeated failure;
  • systemic design issue;
  • documentation-system weakness;
  • training weakness.

Not every qualification deviation necessarily requires a CAPA.


16.28 CAPA Summary

CAPAOriginActionQualification ImpactStatus
CAPA-001DEV-014______Closed
CAPA-002Trend______Open

Where a CAPA remains open, the QSR should evaluate whether qualification/release can proceed with that condition.


16.29 Change Controls

Qualification often identifies or intersects with changes.

Examples:

  • PLC logic modification;
  • component replacement;
  • sensor change;
  • alarm setpoint change;
  • HMI modification;
  • utility modification.

Your source specifically requires change controls to be addressed in the QSR.


16.30 Change-Control Summary

Change ControlDescriptionQualification ImpactVerificationStatus
CC-001PLC modificationOQ regression requiredOQ-RG-01Closed
CC-002Sensor replacementIQ/OQ impactIQ-RT-02/OQ-RT-03Closed

The QSR should demonstrate that qualification reflects the final controlled configuration.


16.31 Final Configuration Is Critical

Imagine:

OQ successfully completed on Software Version 1.0.

Then before release:

Software Version 1.1 installed.

If the QSR simply states:

“OQ Passed”

without assessing Version 1.1, the conclusion may no longer apply to the current configuration.

Therefore:

Qualification evidence must correspond to the configuration proposed for release.


16.32 Traceability Status

The source specifically requires the QSR to assess traceability status.

The report should confirm whether applicable requirements have appropriate lifecycle evidence.

A useful reconciliation is:

Requirement StatusCount
Total applicable requirements___
Verified___
Verified after deviation/retest___
N/A with justification___
Partially verified___
Open___

16.33 Critical Requirement Review

Particular attention should be given to:

  • GMP-critical requirements;
  • safety-critical requirements;
  • data-integrity requirements;
  • critical process-control requirements.

The QSR should not recommend an unrestricted qualified state if a critical requirement remains unresolved without an appropriately justified disposition.


16.34 Outstanding Risks

Your source specifically requires outstanding risks to be evaluated.

Qualification may reduce risk but not necessarily eliminate every risk.

The QSR should therefore ask:

What residual/outstanding risks remain after qualification?

and:

Are those risks adequately controlled for the proposed intended use?


16.35 Residual Risk Table

Risk IDOriginal RiskControlVerificationResidual StatusAcceptable?
RA-005Interlock failureInterlock designOQ-017ControlledYes
RA-009Unauthorized accessRole controlsOQ-SEC-03ControlledYes
RA-014_________OpenAssessment required

The organization’s approved risk methodology should govern acceptance.


16.36 Restrictions and Limitations

Your source specifically requires the QSR to identify restrictions/limitations.

Possible restrictions might include:

  • limited operating range;
  • specific configuration;
  • approved product family only;
  • temporary procedural control;
  • excluded function;
  • restricted software functionality.

Restrictions should not be used to disguise unresolved critical deficiencies.


16.37 Example — Restricted Qualified State

Suppose the machine was successfully qualified between:

20–60 rpm

but its design maximum is:

80 rpm

If 60–80 rpm was not qualified for GMP use, the QSR might recommend qualification only within the demonstrated range.

The release documentation and SOP/recipe controls should remain consistent with that limitation.


16.38 SOP Readiness

The source’s later Part 26 requires SOPs that may need to be available before GMP release, including operation, cleaning, setup/changeover, preventive maintenance, calibration, breakdown handling, alarm response, access management, backup/restore, audit-trail review, data handling, recipe management, logbooks and change control.

Therefore, qualification completion should be considered alongside operational readiness.


16.39 Training Readiness

The source also requires training status to be considered before PQ and routine GMP operation.

Potential training groups include:

  • operators;
  • engineering;
  • maintenance;
  • QA;
  • administrators;
  • automation personnel.

A technically qualified machine operated by untrained personnel is not automatically ready for routine GMP operation.


16.40 Why Successful Protocol Execution Alone Is Not Enough

This is the central principle explicitly required in Part 16.

Consider:

IQ = Pass

OQ = Pass

PQ = Pass

Can the system automatically be released?

Not necessarily.

Other lifecycle elements may remain unresolved.


16.41 Example — Protocols Pass but Traceability Is Incomplete

Suppose:

  • IQ passed;
  • OQ passed;
  • PQ passed;

but:

URS-DI-014 — Backup restoration requirement has no qualification evidence.

The protocol status may appear satisfactory while requirement coverage remains incomplete.

The QSR should identify this gap.


16.42 Example — Protocols Pass but Change Is Unassessed

Suppose:

OQ completed successfully.

After OQ:

PLC program modified.

No documented qualification-impact assessment is performed.

The original OQ result may not adequately represent the configuration proposed for release.


16.43 Example — Protocols Pass but Critical Deviation Is Open

Suppose:

OQ passed after most testing.

However:

Critical reject-function deviation remains unresolved.

The QSR cannot simply ignore the open deviation because the overall protocol completion percentage is high.


16.44 Example — Protocols Pass but SOPs Are Missing

Suppose equipment qualification is technically complete, but:

  • cleaning SOP is not approved;
  • operating SOP is not approved;
  • access-management procedure is unavailable.

Qualification status and GMP operational release therefore need to be distinguished.


16.45 Example — Protocols Pass but Training Is Incomplete

PQ may have been performed by trained qualification personnel, but routine operators remain untrained.

The equipment may have technical qualification evidence while routine GMP operation is not yet ready.


16.46 Qualification Completion vs GMP Release

These are related but distinct decisions.

Qualification Completion

Asks:

Has the required qualification evidence been satisfactorily completed and assessed?

GMP Release

Asks more broadly:

Is the system ready and authorized for its intended GMP operation under the required controls?

The source explicitly places:

Qualification Summary Report → SOP + Training Readiness → QA/GMP Release → Routine Operation.


16.47 Recommended Qualified State

Your source requires the QSR to define a recommended qualified state.

Possible company-defined dispositions might include:

Qualified

Evidence supports intended use.

Qualified With Defined Restrictions

Evidence supports only a documented operating scope.

Qualification Incomplete

Additional evidence/actions required.

Not Qualified

Evidence does not support intended use.

The exact terminology should follow the company’s PQS.


16.48 Qualified With Restrictions

This disposition requires particular care.

Example:

Equipment is recommended as qualified for operation within the demonstrated 20–60 rpm range. Operation above 60 rpm is outside the qualified scope pending approved additional qualification.

The restriction should propagate into:

  • SOP;
  • recipe;
  • training;
  • operational controls;
  • change control.

16.49 Qualification Incomplete

This may be appropriate when:

  • required testing remains open;
  • critical deviations remain unresolved;
  • traceability is incomplete;
  • significant risk remains unassessed;
  • configuration is not controlled.

The report should clearly state what remains necessary.


16.50 Conclusion

The conclusion should integrate the entire body of evidence.

It should not simply say:

All protocols passed. Equipment qualified.

Instead it should consider:

  • qualification scope;
  • executed protocols;
  • acceptance criteria;
  • deviations;
  • retesting;
  • open items;
  • CAPA;
  • changes;
  • traceability;
  • residual risk;
  • restrictions.

16.51 Example QSR Conclusion

Based on review of the qualification activities within the defined scope, including applicable protocol execution, recorded test results, deviations, justified retesting, change controls, requirement traceability and outstanding-risk assessment, the available documented evidence supports the recommended qualification status stated in this report, subject to any restrictions or actions specifically identified herein.

The actual conclusion should reflect the real qualification evidence rather than use predetermined wording.


16.52 QA Disposition

Your source specifically requires QA disposition.

QA’s role should be defined by the company’s PQS.

QA assessment may include confirmation that:

  • qualification package is complete;
  • significant deviations are appropriately dispositioned;
  • retesting is justified;
  • change controls are addressed;
  • traceability is acceptable;
  • outstanding risks are evaluated;
  • restrictions are defined;
  • the recommended qualified state is supported.

16.53 QA Should Not Merely Count Signatures

QA review should challenge the evidence.

Questions include:

Does the conclusion follow from the data?

Are critical failures resolved?

Is the current configuration the tested configuration?

Are requirements traceable?

Are outstanding risks acceptable?

Are restrictions clearly controlled?

The QSR is therefore an important quality decision document.


16.54 Release for GMP Use

The source specifically requires release for GMP use where applicable.

Release may require consideration of more than qualification testing.

A practical readiness model is:

Qualification Complete
        +
Critical Deviations Resolved/
Appropriately Dispositioned
        +
Traceability Complete
        +
Risk Acceptable
        +
Calibration Ready
        +
PM Ready
        +
SOPs Approved
        +
Training Complete
        +
Data/Access Controls Ready
where applicable
        ↓
QA / GMP RELEASE
        ↓
ROUTINE GMP OPERATION

The exact release mechanism is company-specific.


16.55 GMP Release Checklist

Qualification

  • □ DQ completed where applicable
  • □ FAT/SAT appropriately addressed
  • □ IQ completed
  • □ OQ completed
  • □ PQ completed where applicable
  • □ Qualification summary completed

Exceptions

  • □ Deviations assessed
  • □ Failed tests investigated
  • □ Retests justified
  • □ Critical open items resolved
  • □ CAPAs appropriately addressed
  • □ Changes assessed

Traceability/Risk

  • □ Critical URS requirements verified
  • □ Traceability completed
  • □ Outstanding risks evaluated
  • □ Restrictions documented

Operational Readiness

  • □ SOPs approved
  • □ Personnel trained
  • □ Calibration program established
  • □ Preventive maintenance established
  • □ Logbooks available where required
  • □ Access controls established where applicable
  • □ Backup/restore controls established where applicable

Approval

  • □ QSR approved
  • □ QA disposition complete
  • □ GMP release documented where required

These elements align with the source’s final inspection-readiness checklist and release workflow.


16.56 QSR Approval

A practical approval table may be:

FunctionNameSignatureDate
Prepared By — Validation/CQV
Engineering Review
Production Review
Automation/IT Review where applicable
QA Approval

Actual responsibilities depend on the company’s PQS.


16.57 Recommended QSR Attachments

Depending on system complexity, useful attachments may include:

  • protocol execution summary;
  • deviation summary;
  • retest summary;
  • open-item list;
  • CAPA summary;
  • change-control summary;
  • traceability matrix;
  • residual-risk assessment;
  • qualification document index;
  • GMP release checklist.

Avoid unnecessarily duplicating complete controlled documents if references provide adequate traceability.


16.58 Practical QSR Summary Dashboard

CategoryStatus
URSApproved
Risk AssessmentComplete
DQComplete
FATComplete/Leveraged as justified
SATComplete
IQComplete
OQComplete
PQComplete where applicable
DeviationsClosed/Dispositioned
RetestingReviewed
Change ControlsAssessed
TraceabilityComplete
Critical RequirementsVerified
Residual RisksAcceptable/Dispositioned
SOPsReady
TrainingReady
RestrictionsNone / Defined
Recommended StatusQualified / Restricted / Incomplete
QA Disposition______
GMP Release______

16.59 Example — Tablet Compression Machine QSR

Consider the tablet compression machine used throughout the handbook.

The qualification package might contain:

URS-TCM-001
     ↓
Risk Assessment
     ↓
DQ-TCM-001
     ↓
FAT-TCM-001
     ↓
SAT-TCM-001
     ↓
IQ-TCM-001
     ↓
OQ-TCM-001
     ↓
PQ-TCM-001
     ↓
Traceability Matrix
     ↓
QSR-TCM-001
     ↓
QA/GMP Release

The source specifically requires the later worked example to follow:

URS → Impact Assessment → Risk Assessment → DQ → FAT → SAT → IQ → OQ → PQ → Traceability → Summary Report → GMP Release.


16.60 Tablet Compression Machine — Critical Function Review

The QSR might summarize evidence relating to source-required critical tests such as:

  • compression force;
  • pre-compression force;
  • turret speed;
  • fill depth;
  • tablet-weight control;
  • feeder operation;
  • main motor;
  • lubrication;
  • guards;
  • interlocks;
  • emergency stop;
  • reject mechanisms;
  • metal-detector interface where applicable;
  • alarms;
  • recipe management;
  • user access;
  • audit trail;
  • electronic records;
  • power failure/recovery;
  • data backup where applicable.

The QSR need not repeat every raw result but should provide or reference sufficient evidence to support its conclusion.


16.61 Example Critical-Function Summary

Critical FunctionRequirementEvidenceDeviationFinal Status
Compression forceURS-CM-001OQ-005/PQ-002NoneVerified
Turret speedURS-CM-003OQ-008NoneVerified
Guard interlockURS-CM-007OQ-014DEV-004Verified after retest
Emergency stopURS-CM-008OQ-015NoneVerified
User accessURS-DI-002OQ-022NoneVerified
Audit trailURS-DI-004OQ-024NoneVerified
Backup/restoreURS-DI-007OQ-027NoneVerified

These references are illustrative and would need to match the actual controlled package.


16.62 Example QSR Deviation Assessment

Suppose the guard interlock failed initially.

The QSR should show:

OQ-014 → Initial Failure → DEV-004 → Investigation → Controlled Correction → OQ-014-R1 → Pass → Traceability Updated

Then assess whether:

  • related interlocks were affected;
  • regression testing was required;
  • residual risk remains.

This preserves the qualification story.


16.63 Example — Change Before Release

Suppose a PLC change is made after OQ.

The QSR should not automatically recommend release.

The sequence should be:

PLC Change
   ↓
Change Control
   ↓
GMP/Qualification Impact
   ↓
Risk Assessment
   ↓
Required Regression Testing
   ↓
Successful Verification
   ↓
Updated Traceability
   ↓
QSR Assessment
   ↓
Release Decision

This connects directly with Part 17 of the source, which addresses qualification impact from changes.


16.64 Common QSR Deficiencies

DeficiencyConcern
QSR only says IQ/OQ/PQ passedNo lifecycle assessment
Initial failures omittedQualification history incomplete
Deviations listed without impactFinal suitability uncertain
Open items not assessedRelease risk unclear
CAPAs ignoredSystemic actions may remain
Changes not summarizedTested configuration may differ
Traceability not reviewedRequirements may remain unverified
Residual risks not assessedQualified-state rationale incomplete
Restrictions omittedOperation may exceed demonstrated scope
SOP readiness ignoredGMP operational readiness incomplete
Training ignoredRoutine operation may be uncontrolled
Automatic GMP release after PQQualification and release decisions conflated
Generic conclusionEvidence does not clearly support decision

16.65 Inspector Perspective — “Show Me the Qualification Summary”

The inspector’s intent is likely to understand:

How did the organization conclude that the equipment/system was qualified?

Strong evidence should allow navigation from:

QSR → Qualification Protocols → Deviations → Raw Evidence → Traceability → Final Decision

The QSR should function as the roadmap to the complete qualification package.


16.66 Inspector Perspective — “Were There Any Failures?”

A strong response does not attempt to create the impression that qualification was perfect.

Instead:

“Three qualification discrepancies occurred. Each was documented, investigated and assessed. Two required controlled corrective action and retesting. The associated evidence and final disposition are summarized in the QSR.”

The source’s inspection section specifically anticipates questions such as:

  • Show me the deviation.
  • Who approved the re-test?
  • What raw data supports this result?
  • How were qualification failures investigated?

16.67 Inspector Perspective — “How Do You Know All URS Requirements Were Tested?”

The expected evidence is the Traceability Matrix.

The QSR should be able to reference:

URS → Risk → Design → FAT/SAT → IQ/OQ/PQ → SOP/Control → Final Status

This is the traceability model explicitly required in Part 12.


16.68 Inspector Perspective — “Which Configuration Was Released?”

For automated equipment, the QSR should make the final configuration clear.

Potential evidence includes:

  • PLC version;
  • HMI version;
  • SCADA version;
  • firmware;
  • configuration record;
  • approved change history.

A QSR based on an obsolete configuration is not a reliable release basis.


16.69 Inspector Perspective — “What Remained Open?”

A strong response identifies open items transparently and explains:

  • classification;
  • GMP impact;
  • qualification impact;
  • risk;
  • owner;
  • due date;
  • why release was or was not affected.

Potential red flag:

“There were some punch-list items, but we don’t know what they were.”


16.70 Inspector Perspective — “Who Released the Equipment?”

The organization should be able to show:

  • QSR approval;
  • QA disposition;
  • GMP release record where applicable;
  • date of release;
  • applicable restrictions.

The source explicitly requires QA/GMP release before routine operation in its end-to-end lifecycle.


16.71 Qualification Closure Decision Tree

All Planned Qualification
Activities Complete?
       │
   ┌───┴───┐
   NO     YES
   │        ↓
Do Not   Acceptance Criteria
Close    Satisfied?
            │
        ┌───┴───┐
        NO     YES
        │        ↓
   Investigate  Deviations
                Dispositioned?
                    │
                ┌───┴───┐
                NO     YES
                │        ↓
             Do Not   Changes
             Close    Assessed?
                         │
                     ┌───┴───┐
                     NO     YES
                     │        ↓
                  Assess   Traceability
                           Complete?
                               │
                           ┌───┴───┐
                           NO     YES
                           │        ↓
                        Resolve   Residual Risk
                                  Acceptable?
                                      │
                                  ┌───┴───┐
                                  NO     YES
                                  │        ↓
                               Do Not   Restrictions/
                               Release  Controls Defined?
                                           ↓
                                      QSR Conclusion
                                           ↓
                                      QA Disposition
                                           ↓
                                    GMP Release where
                                        applicable

16.72 Recommended QSR Conclusion Categories

A practical decision model may be:

StatusMeaning
QualifiedEvidence supports intended use
Qualified with RestrictionsEvidence supports defined limited use
Qualification IncompleteAdditional work required
Not QualifiedEvidence does not support intended use

These categories are practical examples; the source does not mandate this exact terminology.


16.73 QSR Readiness Checklist

Document Package

  • □ URS approved
  • □ Impact assessment complete
  • □ Risk assessment complete
  • □ DQ complete where applicable
  • □ FAT/SAT addressed
  • □ IQ complete
  • □ OQ complete
  • □ PQ complete where applicable

Test Evidence

  • □ All planned tests reconciled
  • □ Actual results available
  • □ Raw data retained
  • □ Acceptance criteria reviewed
  • □ Failed tests identified
  • □ Retests justified

Exceptions

  • □ Deviations summarized
  • □ Investigations complete
  • □ CAPAs assessed
  • □ Open items assessed
  • □ Punch-list status reviewed

Changes

  • □ Qualification-related changes identified
  • □ Final configuration established
  • □ Required regression/requalification completed

Traceability/Risk

  • □ Traceability matrix complete
  • □ Critical requirements verified
  • □ Outstanding risks evaluated
  • □ Residual risk acceptable
  • □ Restrictions defined

Operational Readiness

  • □ Applicable SOPs approved
  • □ Required training completed
  • □ Calibration program ready
  • □ Preventive maintenance ready
  • □ Access/data controls ready where applicable

Closure

  • □ Conclusion supported
  • □ Recommended qualified state defined
  • □ QA disposition complete
  • □ GMP release documented where applicable

This aligns with the source’s final documentation-quality checklist, which specifically requires deviations to be resolved or appropriately dispositioned, retests justified, traceability completed, outstanding risks evaluated, SOPs approved, training completed, summary report approved and QA release documented where required.


16.74 Master Qualification Summary Report Template

QUALIFICATION SUMMARY REPORT

1. Document Information

System/Equipment: __________________________
Equipment ID: ______________________________
Location: __________________________________
Report No.: ________________________________
Revision: __________________________________

2. Objective


3. Scope


4. Equipment/System Description


5. Intended Use


6. Qualification Strategy


7. Qualification Documents Executed

DocumentNumberRevisionStatus
DQ
FAT
SAT
IQ
OQ
PQ

8. Test Summary

StagePlannedExecutedInitial FailuresRetestsFinal Status
IQ
OQ
PQ

9. Deviations


10. Open Items


11. CAPAs


12. Change Controls


13. Acceptance-Criteria Status


14. Traceability Status


15. Outstanding/Residual Risks


16. SOP/Training Readiness


17. Restrictions/Limitations


18. Overall Assessment


19. Conclusion


20. Recommended Qualified State

□ Qualified
□ Qualified with Restrictions
□ Qualification Incomplete
□ Not Qualified

21. QA Disposition


22. GMP Release

□ Released where applicable
□ Not Released
□ Released with documented restrictions

23. Approval

FunctionNameSignatureDate
Prepared By
Reviewed By
Engineering
Production
QA

16.75 QSR Executive Summary Example

A useful executive summary might state:

Qualification activities for the identified equipment/system were reviewed against the approved qualification scope and applicable requirements. The assessment included executed qualification protocols, acceptance-criteria status, deviations and retesting, change controls, requirement traceability, open items and outstanding risks. The resulting qualification recommendation and any applicable restrictions are documented in this report for QA disposition and subsequent GMP-release consideration.

This wording intentionally avoids assuming the system passed before the evidence has been assessed.


16.76 QSR Quality Test

Before approving a QSR, ask five questions:

1. Completeness

Did we perform everything required by the approved qualification strategy?

2. Compliance

Did the evidence satisfy the applicable predefined acceptance criteria?

3. Exceptions

Do we understand and appropriately disposition every significant failure, deviation and change?

4. Traceability

Can every critical applicable requirement be traced to adequate evidence?

5. Fitness for Intended Use

Does the total body of evidence actually support the proposed qualified state?

If these questions cannot be answered satisfactorily, the QSR may not be ready for closure.


16.77 Golden Rule of the Qualification Summary Report

The purpose of the QSR is not to prove that qualification paperwork has been completed; it is to make a documented, evidence-based determination of what the completed qualification package actually demonstrates.

Therefore:

IQ Pass + OQ Pass + PQ Pass ≠ Automatic GMP Release

The broader decision requires consideration of:

Requirements + Risks + Tests + Raw Evidence + Deviations + Retesting + Changes + Traceability + Residual Risk + Restrictions + Operational Readiness + QA Disposition


16.78 Part 16 — Key Takeaway

The source requires the Qualification Summary Report to integrate:

Objective → Scope → Equipment/System → Protocols Executed → Test Summary → Deviations → Open Items → CAPAs → Change Controls → Acceptance-Criteria Status → Traceability Status → Outstanding Risks → Restrictions/Limitations → Conclusion → Recommended Qualified State → QA Disposition → Release for GMP Use where applicable.

A strong QSR should therefore establish a defensible closure chain:

Qualification Plan/Requirements → Risk → DQ/FAT/SAT → IQ/OQ/PQ → Raw Evidence → Deviations/Retests → Change Controls → Traceability → Residual Risk → QSR → Qualification Recommendation → SOP/Training Readiness → QA/GMP Release

Most importantly:

Successful execution of individual qualification protocols demonstrates only that those protocols were executed and their results were obtained. The final decision on fitness for intended GMP use requires assessment of the complete qualification lifecycle and the state of control proposed for routine operation.

Next — Part 17: Change Control

The next part requires detailed evaluation of qualification impact arising from:

Component replacement, instrument replacement, PLC changes, software upgrades, HMI/SCADA modifications, recipe changes, utility changes, equipment relocation, process changes, capacity changes, new products, new operating ranges and material-of-construction changes.

The required decision model is:

Change → GMP Impact → Risk Assessment → Qualification Impact → Required Testing → Documentation Update → Approval → Implementation → Verification → Closure.

About the Author

Ramesh Palav is a pharmaceutical professional with 20+ years of industry experience in manufacturing, GMP, quality systems, validation, compliance, and operational excellence. Through Pharma Manufacturing Hub, he shares practical insights on pharmaceutical careers, manufacturing, quality, validation, Pharma 4.0, AI, and professional development.

His goal is to help students, freshers, experienced professionals, and career-break professionals build the knowledge and skills needed to succeed in the pharmaceutical industry.

Leave a Comment

Scroll to Top
